Skip to content
ATG.H2OHelp
Try the demo

Creating a schedule

Manual — Automatic Scheduling · chapter 3 of 8

In Planning › Automatic Scheduling, click New Schedule. The wizard has four steps — General, Assets, Plans and Confirmation — and nothing is saved until the Generate Schedule button of the last step. Next is only enabled when the step is complete; Back goes back without losing what was filled in.

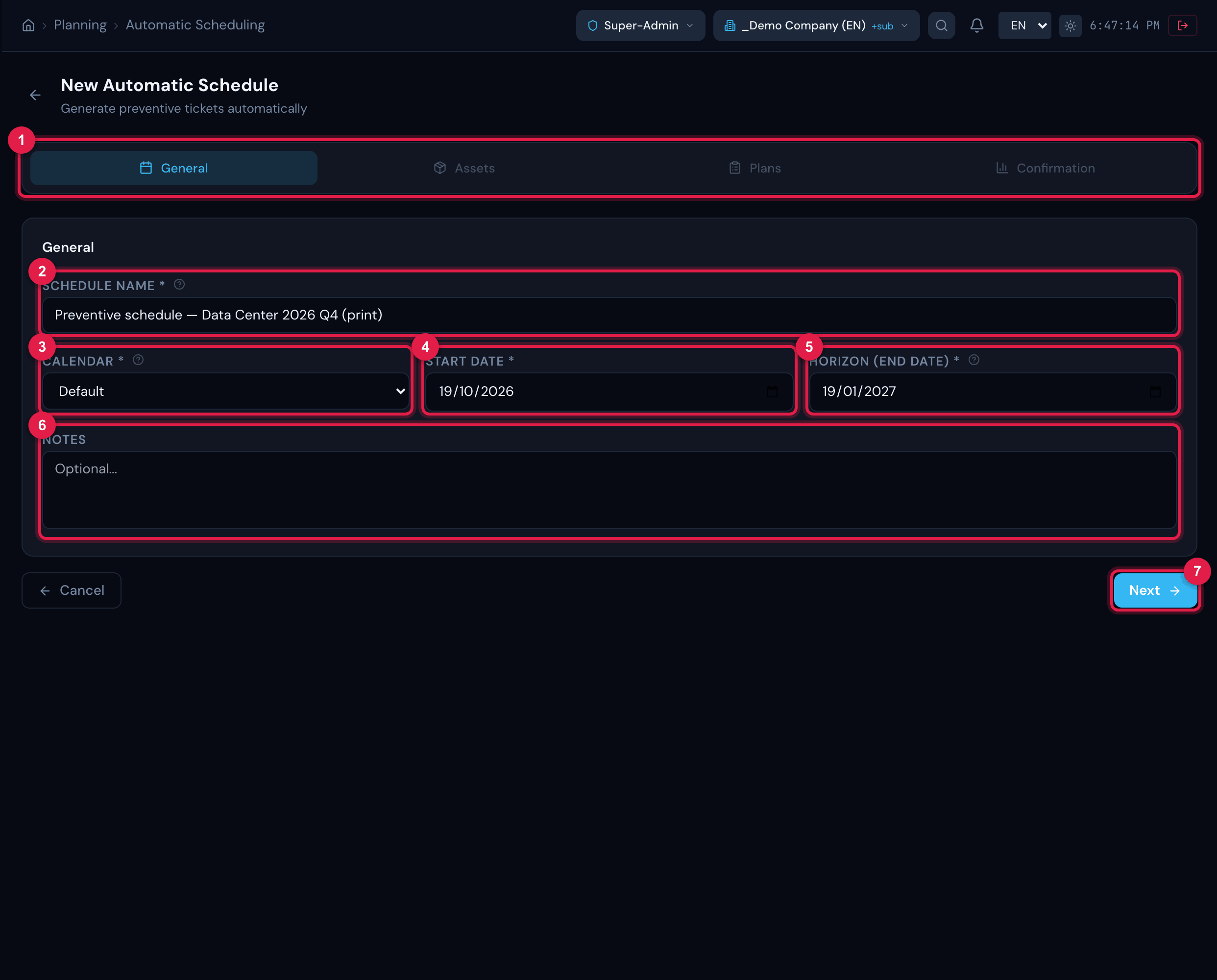

New Automatic Schedule, step General: name, calendar, start date, horizon and notes.

Figure 4. New Automatic Schedule, step General: name, calendar, start date, horizon and notes.

  1. 1The four steps — the current one highlighted; the ones already done get a check mark and can be reopened.
  2. 2Schedule Name — e.g. “Preventive schedule — Data Center 2026 Q4”.
  3. 3Calendar — required; the company’s calendars (chapter 2).
  4. 4Start Date — the first day of the horizon.
  5. 5Horizon (End Date) — until when to generate.
  6. 6Notes — free text, optional.
  7. 7Next — only with the four required fields filled in.
  • The End Date must be after the Start Date; H2O refuses to save otherwise (chapter 8).
  • Horizons of 3 to 12 months work well: all tickets are created at once, and a long horizon fills the ticket list with Planned tickets. For the next period, create another schedule starting the day after this one ends.
  • The field hint says the horizon “can be extended later”; today there is no screen for that — the rule above applies.

Choose the Asset Type (UPS, Generator sets, Air conditioning, Switchboards…), tick the assets and give each one its preferred day. Above the asset type is the No asset (the asset comes from the template) option, for when the asset is already linked in the template itself (next section). Next is enabled with at least one ticked asset or with that option.

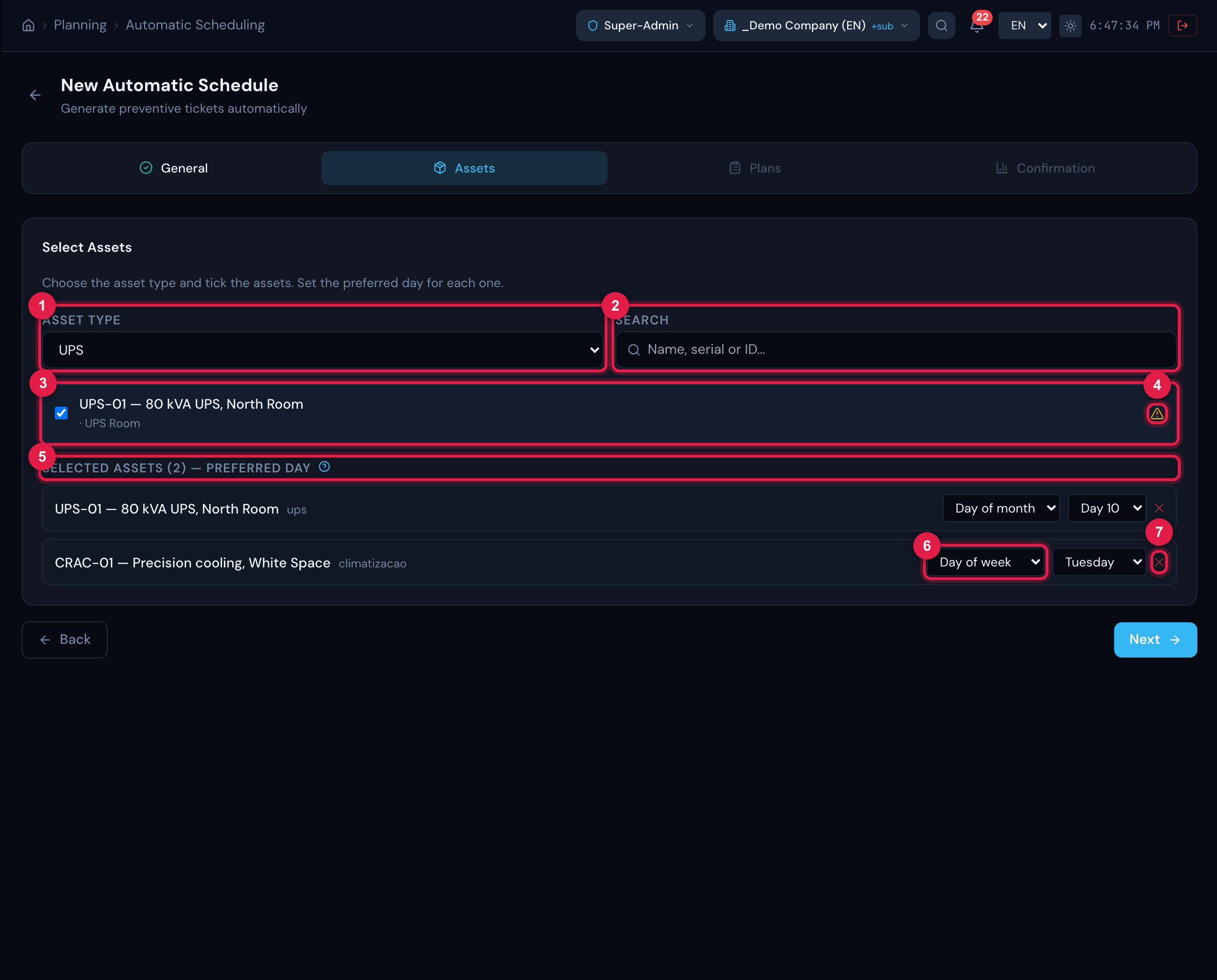

Step Assets: the chosen type, the list of assets with the search and, below, the Selected Assets with each one's Preferred Day.

Figure 5. Step Assets: the chosen type, the list of assets with the search and, below, the Selected Assets with each one’s Preferred Day.

  1. 1Asset Type — one type at a time; the ticked assets are kept when you switch type.
  2. 2Search — by name, serial number or ID.
  3. 3A ticked asset — the row shows the serial and the location.
  4. 4Warning Already in a schedule: … — the asset is already in another Active schedule (hover to see which). You may go on; it is only a warning against duplication.
  5. 5Selected Assets (N) — Preferred Day: one asset per row.
  6. 6Day of month (Day 1 to 28) or Day of week (Monday to Sunday).
  7. 7✕ — removes the asset from the selection.
Preferred day How H2O calculates the dates Use with
Day of month (1–28) the first date is that day in the month of the Start Date; if it has already passed, a whole period is skipped. Then the plan’s interval is added, always on the same day of the month. The limit of 28 avoids short months. Monthly, Bimonthly, Quarterly, Semi-annual, Annual, Custom ≥ 28 days
Day of week the first date is the first chosen day of the week from the Start Date (inclusive); then the plan’s interval is added. Weekly, Biweekly, Custom < 28 days
Daily plan one ticket per working day of the calendar, from the Start Date to the horizon; a non-working day is skipped, not moved (with a calendar of 7 working days, every day gets one). The preferred day does not apply. Daily, Custom of 1 day
  • A plan shorter than 28 days (Weekly, Biweekly, Custom < 28) is never tied to the Day of month: with Day of month, the first visit is the Start Date, and the following ones add the interval.
  • The same item never gets two tickets on the same day.
  • In the Plans step, the daily template shows Daily: one ticket per working day of the calendar (the preferred day does not apply).

Spreading the preferred days — UPS on the 10th, switchboards on Wednesday, cooling on Tuesday — distributes the team’s load across the month.

Scheduling without an asset (the asset comes from the template)

Section titled “Scheduling without an asset (the asset comes from the template)”

In some templates the asset is already inside the template: each measurement item points to the equipment it measures. A plant-room template can link, in the same checklist, the temperature to the CRAC, the load to the UPS and the voltage to the switchboard; in this manual’s “Monthly infrastructure inspection — Data Center”, the item “Booster pump BR-01 — operation and running readings” is linked to the asset BR-01 — Booster Pump. The link is made on the template item, with Link asset (Task templates manual, chapter 4, section on the asset linked to the item — the same link the Patrol uses). For those templates, and for routines that do not belong to a single asset, tick No asset (the asset comes from the template): instead of one ticket per asset, you get one ticket per visit, linked to all the template’s assets.

Step Assets with the No asset (the asset comes from the template) option ticked: under Selected Assets, the No asset (from the template) row with its preferred day.

Figure 6. Step Assets with the No asset (the asset comes from the template) option ticked: under Selected Assets, the No asset (from the template) row with its preferred day.

  1. 1No asset (the asset comes from the template) — tick it to schedule by the template. The hint below sums up the rule: one ticket per occurrence, linked to the template assets.
  2. 2The No asset (from the template) row under Selected Assets — it counts in the number in brackets.
  3. 3The row’s own preferred day — Day of month (starts on the 10th) or Day of week, with the same rule as the assets (table above).
  4. 4✕ — removes the option (the same as unticking the box).

The option can be combined with assets of families in the same schedule: tick the box and, below, choose the type and the assets as usual. Each one keeps its own preferred day.

In the Plans step, the option becomes a block of its own, like the family blocks:

Step Plans with the No asset (from the template) block: each template shows how many assets its items have linked; the ticked template has one, the next one has none.

Figure 7. Step Plans with the No asset (from the template) block: each template shows how many assets its items have linked; the ticked template has one, the next one has none.

  1. 1No asset (from the template) block and, on the right, N plan(s) · one ticket per occurrence.
  2. 2The ticked template — “Monthly infrastructure inspection — Data Center”.
  3. 3🔗 N asset(s) linked in the template — how many asset links the template’s measurement items have. Those are the assets the ticket will carry.
  4. 4In amber, no asset linked in the template — the ticket has no asset: you may tick it, but the ticket is born with no asset at all.
  5. 5Total: N asset × plan combination(s) — each plan ticked in the No asset block counts as one combination.
  • Each plan ticked in the No asset block becomes a schedule item, which generates one ticket per occurrence of the plan (what goes into it is in chapter 4).
  • The block without a plan is shown in amber and locks Next, like any family. With more than one block, Apply to all families also ticks the plan in the No asset block; check that this is what you want.
  • The Already in a schedule: … warning does not apply here: the wizard does not check whether the template’s assets are already in another schedule.
  • In the Confirmation step, the Assets card counts only real assets (the No asset row is left out); the asset list shows No asset (from the template) with its day, and Plans per family shows the block with N plan(s) · one ticket per occurrence. Estimated Tickets counts one ticket per occurrence of each plan in the block.

Plans are ticked per asset family: the wizard shows one block for each family that entered in step 2 (UPS, Generator sets…), and a plan ticked in a block applies to every asset of that family. The same plan may be ticked in more than one family.

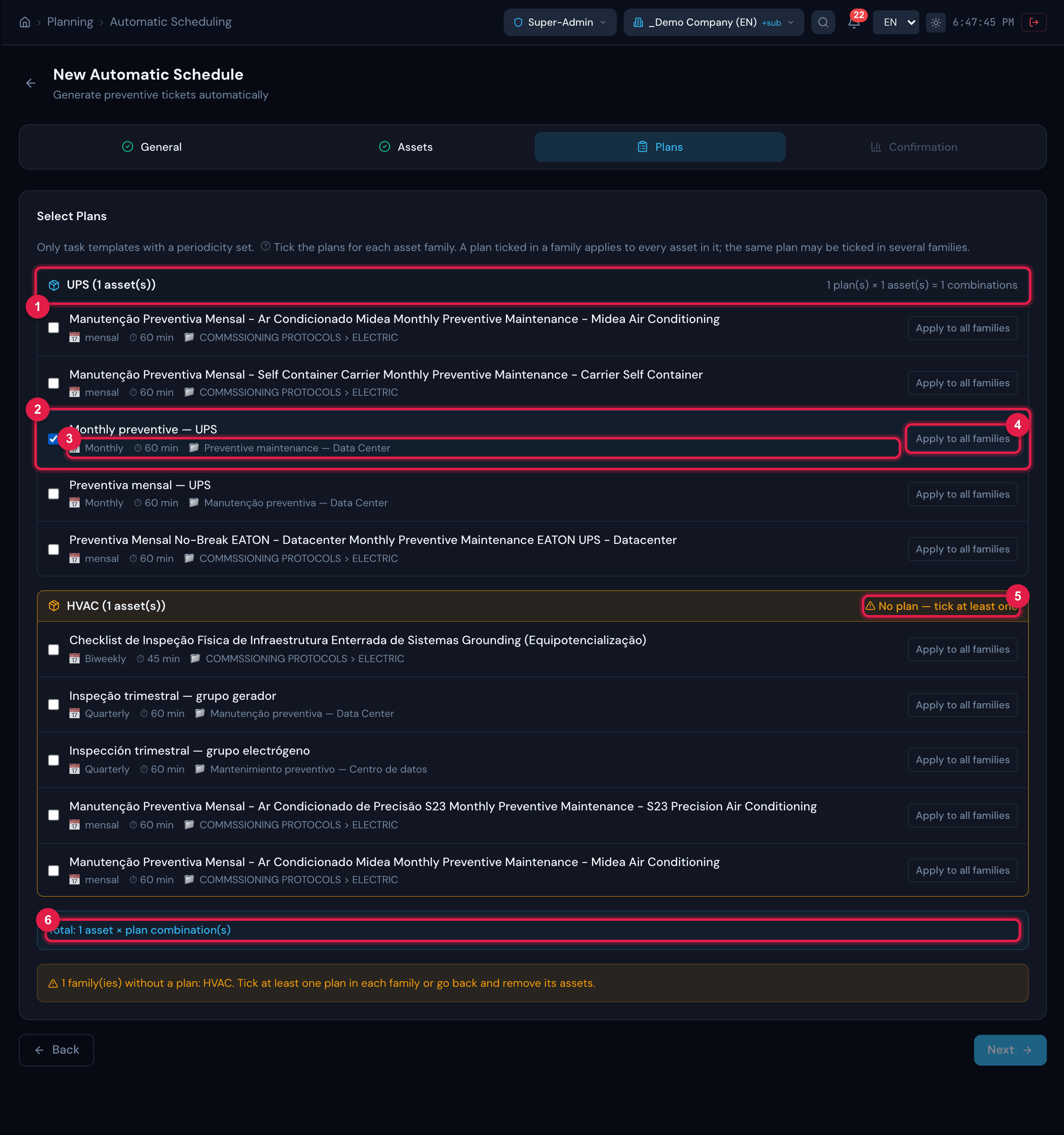

Step Plans: one block per selected asset family, with the templates with a periodicity; a family without a plan is shown in amber; below, the total of combinations.

Figure 8. Step Plans: one block per selected asset family, with the templates with a periodicity; a family without a plan is shown in amber; below, the total of combinations.

  1. 1Family block — UPS (1 asset(s)) — and, on the right, the count P plan(s) × A asset(s) = N combinations of that family.
  2. 2A plan ticked in that family.
  3. 3Periodicity, duration and category of the template (chapter 2).
  4. 4Apply to all families — ticks the plan in every family at once (shown only with more than one family); it becomes In all families — remove when it is already in all of them.
  5. 5Family No plan — tick at least one (in amber): Next stays locked while a family has no plan.
  6. 6Total: N asset × plan combination(s) — each combination becomes a schedule item.

The list brings the templates with a periodicity of the site active in the header and the recursive templates of the sites above it. A template of another site, or of a site above without the recursive option, does not appear.

If the list comes up empty (No template with a periodicity found), fill in the Periodicity in the templates (chapter 2) and come back. With a family without a plan, the warning N family(ies) without a plan: … asks you to tick a plan in it or go back and remove its assets.

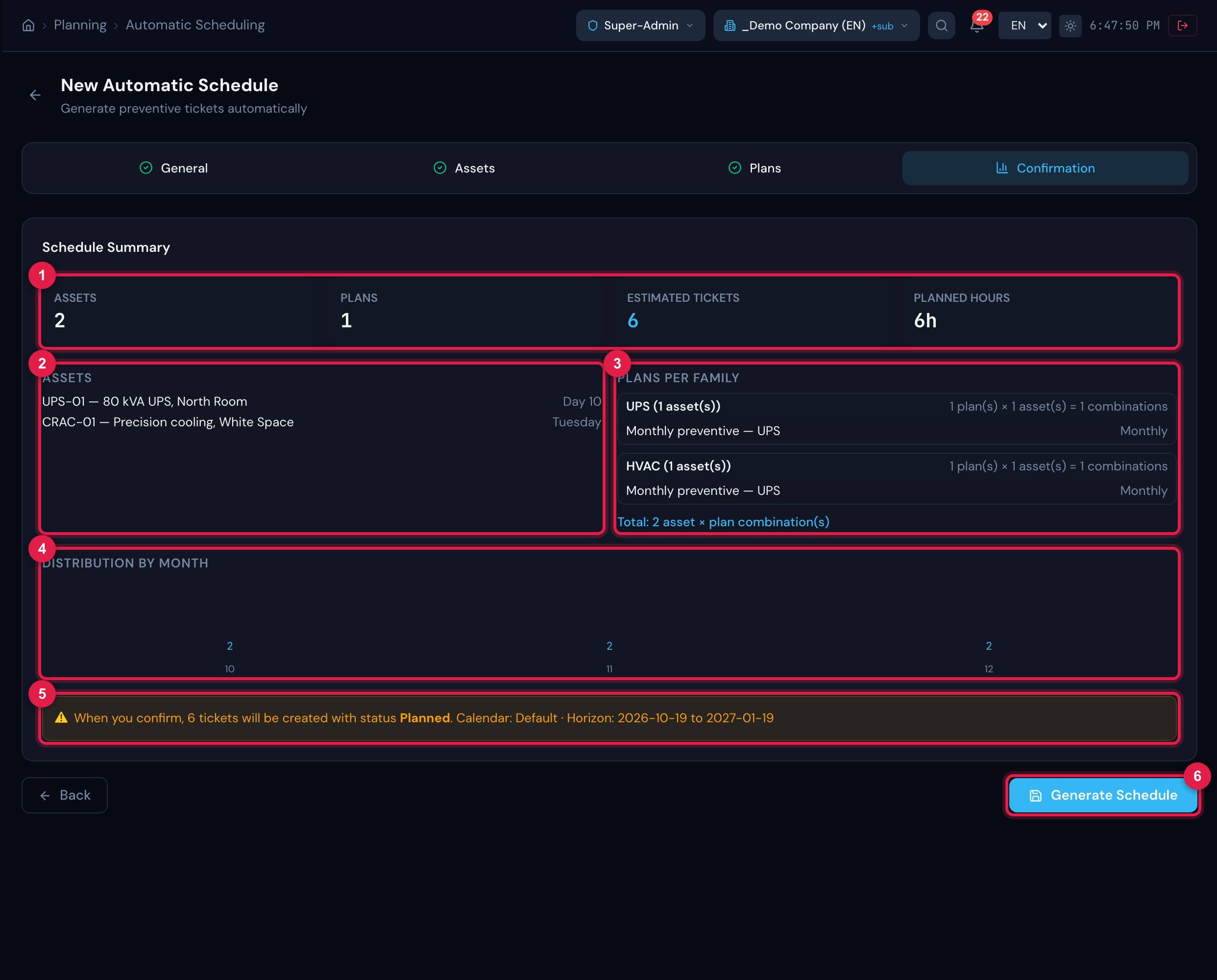

Step Confirmation: the Schedule Summary with the totals, the assets with their preferred day, the plans, the Distribution by Month and the final warning.

Figure 9. Step Confirmation: the Schedule Summary with the totals, the assets with their preferred day, the plans, the Distribution by Month and the final warning.

  1. 1Assets, Plans, Estimated Tickets and Planned Hours.
  2. 2The assets, each with its preferred day.
  3. 3Plans per family — each family with its ticked plans and the combinations count; below, the total.
  4. 4Distribution by Month — how many tickets per month.
  5. 5Warning: When you confirm, N tickets will be created with status Planned. and the chosen calendar and horizon.
  6. 6Generate Schedule — saves and creates all the tickets.
  • Estimated Tickets, Planned Hours and Distribution by Month come from the same calculation as the generation — calendar, preferred day, daily plan —, done on the server without saving anything: the number matches the message Schedule created! N tickets generated. If the server does not answer, the screen shows a rough estimate (30-day months).
  • Above 500 tickets the warning Large schedule: N tickets will be created at once. appears. For a daily plan, prefer a short horizon (1 to 3 months) or a routine driven by the template, in the No asset block — one ticket per day with all the template assets.
  • Planned Hours = tickets × plan duration (30 min when the template has no duration).
  • When you click Generate Schedule, H2O saves the schedule, the items and all the tickets in a single operation: either everything is saved, or nothing. It then opens the schedule page.
  • Generation sends no notification to anyone: the ticket is born with no technician assigned and no requester other than the person who generated it. The plan’s technician goes on the task (chapter 4). Close to the visit date, the bell starts showing the preventive due-soon and overdue alerts (chapter 7).
  1. Check the site in the header and click New Schedule.
  2. Fill in Name, Calendar, Start Date and Horizon and click Next.
  3. Choose the Asset Type, tick the assets and adjust each one’s Preferred Day — or tick No asset (the asset comes from the template), if the asset comes from the template. Next.
  4. Tick the plan (preferably one per schedule). Next.
  5. Review the summary and click Generate Schedule.
