Automatic Scheduling: concepts
Manual — Automatic Scheduling · chapter 1 of 8
Automatic Scheduling creates, in one go, all the preventive maintenance tickets of a period: you choose the assets (a UPS, a generator set, the precision cooling units, a low-voltage main switchboard), the plans (what to do and how often) and the horizon (until when), and H2O calculates the dates, moves the ones that fall on a weekend or holiday and records a Planned ticket for each visit, already with the plan’s task and checklist.It was designed for those who operate critical infrastructure — data centers, substations, hospitals, industrial plants — and need the monthly UPS preventive, the quarterly generator inspection or the CRAC filter cleaning to happen on the right date, without someone opening ticket after ticket. It serves building maintenance on a construction site or in a condominium just as well.
| Term | What it is |
|---|---|
| Schedule | the whole: name, site, calendar, start date, horizon and the items. Each schedule is a row in the list. |
| Schedule item | an asset × plan pair, with the asset’s preferred day — or a plan without an asset, when the assets come from the template itself (chapter 3). The item is what generates the sequence of tickets. |
| Plan | a task template with Periodicity filled in (Knowledge › Templates). It carries the checklist, the expected duration, the category and the technician (chapter 2). |
| Horizon | the End Date: until when to generate tickets. All tickets are created at the moment the schedule is generated — nothing is created later, not even when the horizon arrives. |
| Calendar | defines working days and holidays. A date that falls on a non-working day goes to the nearest working day (chapter 2). |
| Planned ticket | the generated ticket. It is an ordinary H2O ticket, with status Planned, preventive modality, one task with the plan’s template and the asset linked (chapter 4). |
The schedule is not a “robot” that keeps running: when you click Generate Schedule, H2O creates every ticket of the horizon and that is it. For the next period, you create a new schedule.
Where it is
Section titled “Where it is”In the menu Planning › Automatic Scheduling. The screen opens with the list of schedules of the site chosen in the header (and of the sites below it), with search by name.

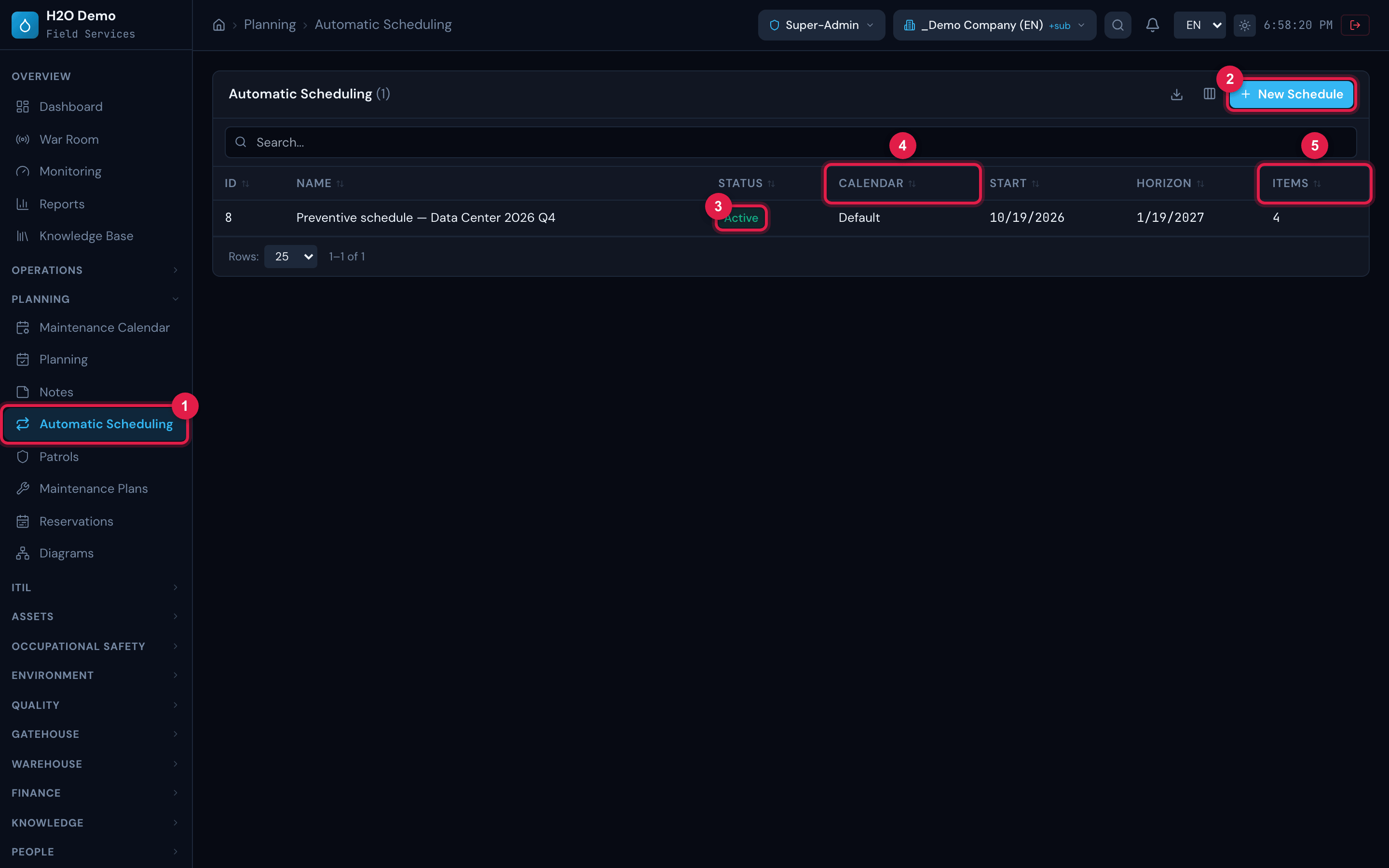

Figure 1. Planning › Automatic Scheduling: the list with ID, Name, Status, Calendar, Start, Horizon and Items, and the New Schedule button.
- 1Menu Planning › Automatic Scheduling.
- 2New Schedule — opens the wizard (chapter 3). Only shown with the Create right in Tickets.
- 3Schedule Status — Active for every schedule created on screen; the PMOC schedule becomes Finished when the PMOC is archived (below).
- 4Calendar, Start and Horizon (end date).
- 5Items — how many asset × plan pairs the schedule has.
| Column | What it shows |
|---|---|
| ID | the schedule number. |
| Name | the name given in the wizard (the list truncates long names; the detail page shows it in full). |
| Status | Active, Paused, Finished or Cancelled. The screen has no button to pause, finish or cancel: a schedule created on screen is born Active and stays so until it is deleted (chapter 6). The PMOC schedule becomes Finished when the PMOC is archived (below). |
| Calendar | the calendar used to adjust the dates. |
| Start / Horizon | the period in which the tickets were generated. |
| Items | the number of asset × plan pairs. |
Click a row to open the schedule page: summary, calendar of tickets and items (chapters 5 and 6).
Schedules created by the PMOC
Section titled “Schedules created by the PMOC”Not every schedule in the list is born in the wizard. The PMOC module (Operations › PMOC) uses Automatic Scheduling to carry out the air-conditioning plan: on the PMOC’s Schedule tab, the Generate schedule button creates a schedule named PMOC · PMOC name, with one item per air-conditioning unit × PMOC activity, and generates the tickets at once, like the wizard.
- Calendar: the one chosen in Schedule calendar on the PMOC. If empty, H2O uses the site’s calendar (or that of a site above) and, if there is none, the first one registered.
- Start and horizon: from the start of the PMOC’s validity (or today) to the end of the validity. A PMOC with no validity end generates 12 months.
- Generating again does not duplicate: the PMOC reuses the same schedule and only adds the missing items (a new unit or activity), generating their tickets from today to the end. It is the only way for an item to enter a schedule that was already generated.
- Activity deactivated or removed on the PMOC: on the next generation its item becomes Inactive and the tickets still only planned go to the trash, by the same rule as Remove item (chapter 6).
- Archiving the PMOC (or activating another PMOC on the same site, which archives the previous one) makes the schedule Finished and shortens the horizon to today. Nothing is deleted: the tickets already generated stay.
Access rights
Section titled “Access rights”Automatic Scheduling has no right of its own: it uses the profile’s Tickets right (People › Profiles › profile › Permissions tab), because everything it does is create and move tickets.
| Level in Tickets | What it allows in Automatic Scheduling |
|---|---|
| Read | see the list, the page and the calendar of the schedules. |
| Create | New Schedule and Generate Schedule. |
| Update | Move Ticket on the calendar and Remove item. |
| Delete | Delete schedule; and, when removing an item, send the still-only-planned tickets to the trash (chapter 6). |
