Calendars
Manual — Locations and calendars · chapter 8 of 9
A calendar says when the company works. It has a name, the working hours of each weekday (a day can have more than one time range, such as 08:00–12:00 and 13:00–18:00; a day without a range is a non-working day) and a list of holidays. H2O uses the calendar to count the SLA deadlines in business hours and to move scheduled dates off weekends and holidays.The Calendars screen
Section titled “The Calendars screen”Configuration › Calendars holds the list of the company’s calendars, with the number (ID) and the Name, in alphabetical order. The list is there to check which calendars exist and what each one is called — that name is what appears in the Calendar fields of the other screens.

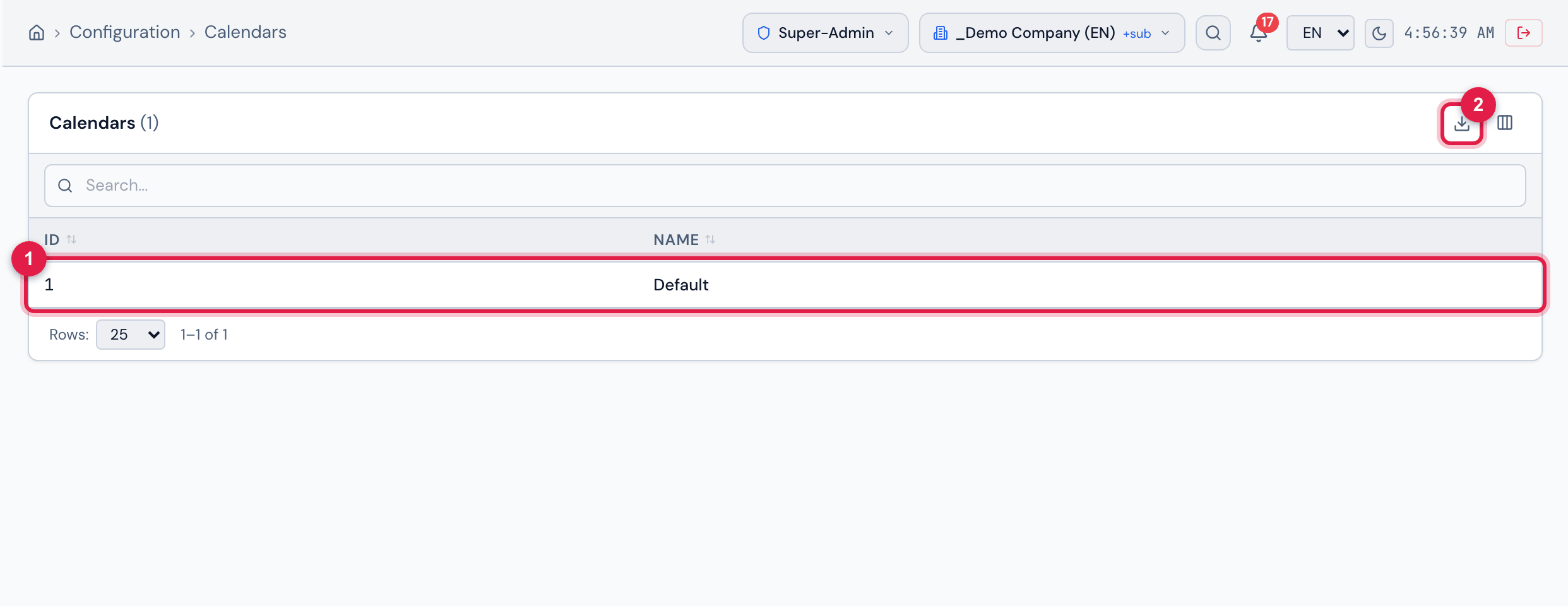

Figure 11. Configuration › Calendars: the list with the ID and Name of each calendar.
- 1A calendar — its name is what appears in the Calendar fields of the SLA, of Automatic Scheduling and of the Maintenance Plans.
- 2Export — Excel or PDF of the list.
Where the calendar is used
Section titled “Where the calendar is used”| Where | Field | What the calendar does |
|---|---|---|
| ITIL › Service Levels — each SLA and OLA | Calendar | counts in business hours the response and resolution deadlines of the ticket, the paused time and the SLA consumption in the report (below). Without a calendar on the SLA — or with a calendar without working hours —, everything is counted in elapsed time. |
| ITIL › Service Levels — Escalation levels of each SLA | the SLA Calendar | the time before or after the deadline at which each level fires is counted in business hours of that calendar. |
| Operations › PMOC | Schedule calendar | the dates of the PMOC tickets that fall on a non-working day move to the nearest working day, as in Automatic Scheduling. Empty: H2O uses the calendar of the PMOC site — or, if it has none, that of the nearest site above; if there is none, the company’s first calendar. |
| Planning › Automatic Scheduling | Calendar (required) | generated dates that fall on a non-working day move to the nearest working day. |
| Planning › Maintenance Plans | Adjust to working day + Calendar | the plan’s next due date that falls on a non-working day moves to the nearest working day. |

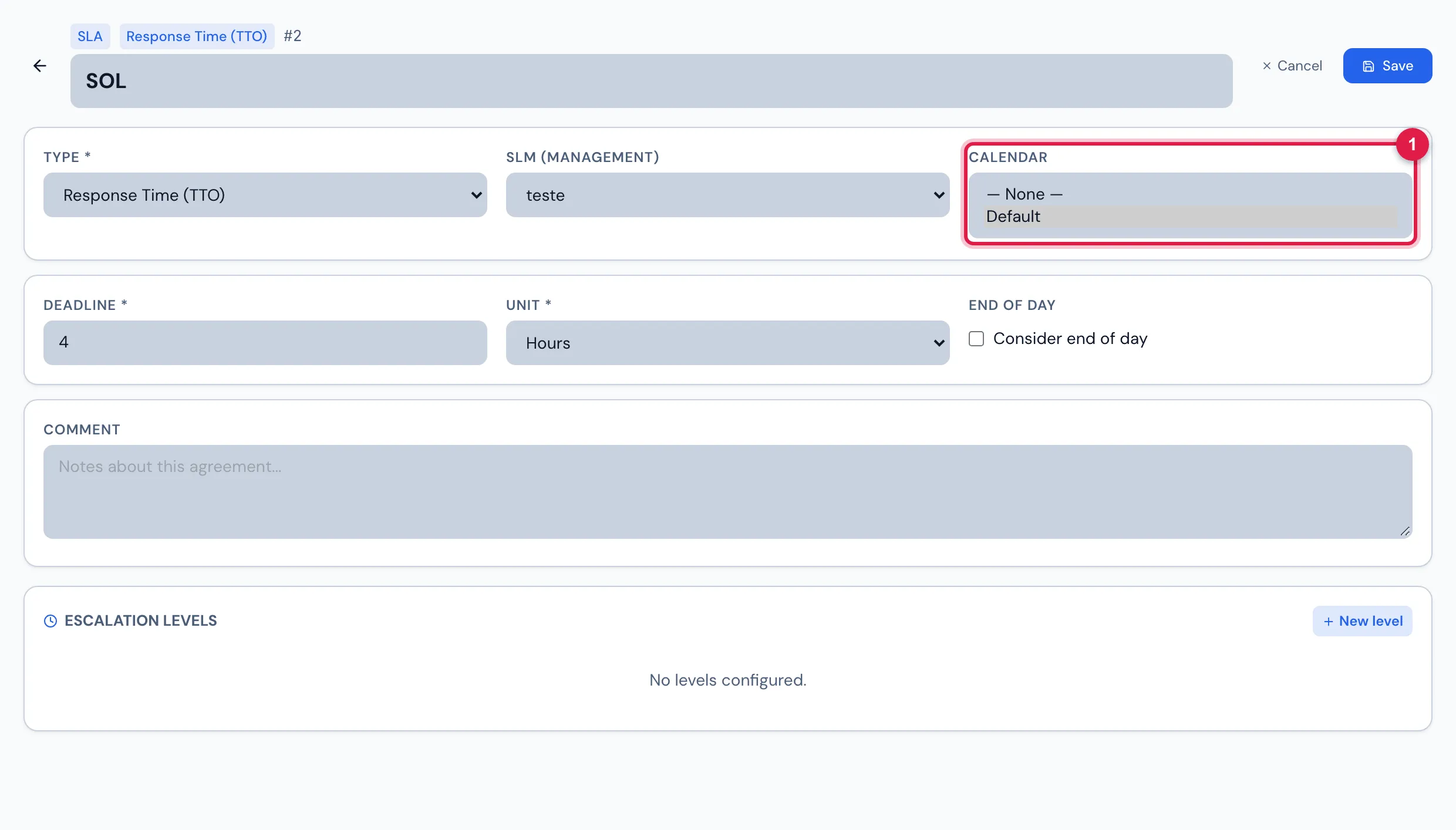

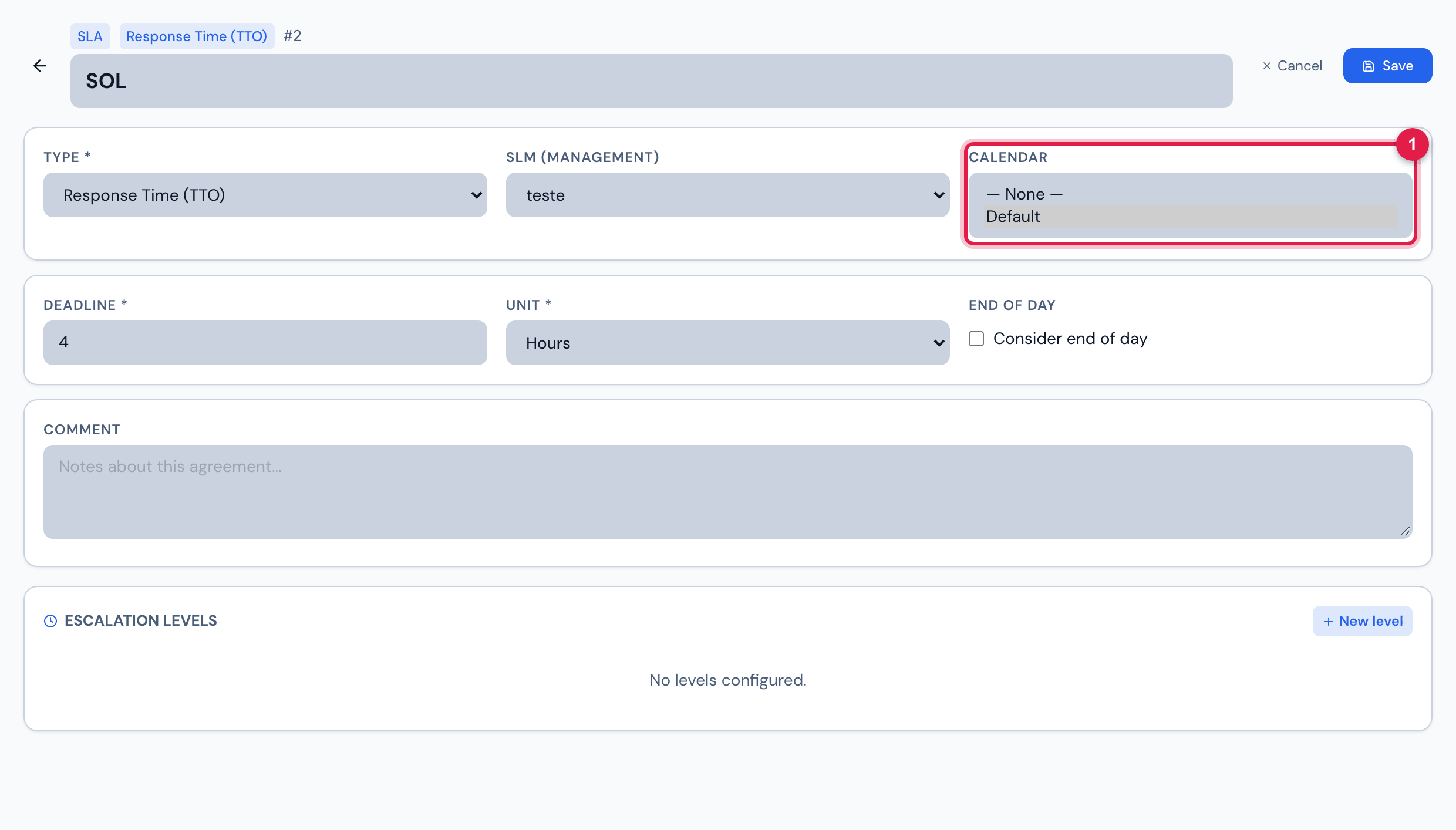

Figure 12. ITIL › Service Levels › an SLA being edited: the Calendar field, with the company’s calendars and — None —; the Consider end of day option; below, the Escalation levels, with the box of a new level open.
- 1Calendar field of the SLA.
- 2Consider end of day — moves deadlines in days and months to the end of the working day.
- 3When — the level time before, at or after the resolution deadline, counted in business hours of the SLA calendar.
In the SLA
Section titled “In the SLA”With a calendar on the SLA (or on the OLA), the ticket deadlines — response (TTO) and resolution (TTR) — are counted in the working hours of that calendar, from the opening. Without a calendar, or with a calendar without any time range, the count is in elapsed time, 24 hours a day.
| SLA unit | How the deadline is counted with a calendar |
|---|---|
| Minutes and Hours | adds only the time inside the time ranges. A ticket opened outside working hours starts counting at the beginning of the next range. Example, with a Monday-to-Friday calendar, 08:00–18:00: a 4-hour SLA opened on Friday at 17:00 is due on Monday at 11:00 (1 hour on Friday and 3 on Monday). |
| Days | adds N working days and keeps the opening time. The opening day does not count; weekends and holidays are skipped. If the time falls outside working hours, the deadline moves to the beginning of the next range. Example: a 1-day SLA opened on Friday at 10:00 is due on Monday at 10:00. An old SLA in weeks counts N × the working days of the calendar week (Monday to Friday, 1 week = 5 working days). |
| Months | adds N ordinary calendar months (there is no “working month”). If the result falls on a non-working day or outside working hours, it moves to the beginning of the next range. |
- Consider end of day — in SLAs in Days and Months, the deadline becomes the end of the working day of the day found (the end of the last range of the day). Example: a 2-day SLA opened on Monday at 10:00 is due on Wednesday at 18:00, not at 10:00. In SLAs in minutes and hours, the option changes nothing.
- When the deadline is calculated — when the ticket is opened and when its SLA is changed. Changing the calendar or the time of an SLA does not recalculate tickets already open.
- Pause — when the ticket enters a status marked as Pauses SLA (System › Ticket Statuses) and later leaves it, the stopped time is measured in business hours of the SLA calendar and the due date is pushed forward by that same business time. Without a calendar, the pause is measured and added in elapsed time. The response deadline (TTO) does not pause.
- Report — in Reports › Tickets, the SLA column shows how much of the deadline has already been consumed in business hours, according to the SLA calendar: the percentage, how far past the deadline (for an open, overdue ticket) or, for a closed one, Within / Breached. Hover over the bar to see the time spent and the deadline. When the SLA has no calendar, the count is in elapsed time and the bar gets a ~ next to it (SLA without a calendar: elapsed time).
- The OLA uses its own calendar. The Calendar field of the service level (SLM) is stored, but the calculation uses the calendar of each SLA and OLA: choose the calendar in each one.
- Escalation levels — in the SLA record, each level fires some time before the deadline, at the deadline or after the deadline for resolution, counted in business hours of the same calendar. The levels only act with escalation turned on in the Escalation box of the Service Levels screen.
In Automatic Scheduling and Maintenance Plans
Section titled “In Automatic Scheduling and Maintenance Plans”- A non-working day is a weekday without any time range in the calendar, or a holiday. A calendar without any working hours registered is treated as Monday to Friday.
- A date that falls on a non-working day moves to the nearest working day: H2O tries the previous day first, then the next one, then two days before, two days after, and so on, up to 7 days. Example: with Saturday and Sunday as non-working days, a Saturday preventive moves to Friday; a Sunday one, to Monday.
- In Automatic Scheduling, the calendar is required: without it, the registration does not move forward.
- In Maintenance Plans, the adjustment only happens with Adjust to working day ticked (in the plan registration, Adjust due dates to working days). If the plan has no calendar chosen, H2O uses the company’s first calendar.
Holidays
Section titled “Holidays”- Each holiday has a start date and an end date — a holiday of several days (such as a year-end break) covers every day of the period.
- A recurring holiday repeats every year on the same day and month: registered once, it is valid forever. This also applies to a period that crosses the year (for example, a break from 12/24 to 01/02 covers 12/31 and 01/01 of every year).
- A non-recurring holiday applies only on the registered dates — Carnival, whose date changes, must be registered every year.
- The same holiday rule applies to the SLA (pause and report), to Automatic Scheduling and to the Maintenance Plans.
